When examining real workflow data, there’s a common pattern: clusters of tasks that have aged significantly, some clearly stagnating beyond recognition acceptable timeframes. These cases point to one of the most important yet very often overlooked metrics in flow management: WIP Aging.

WIP (Work In Progress) Aging measures the elapsed time that a work item has spent in active progress but remains incomplete. This metric serves as an early warning system for workflow problems, helping teams identify where work gets stuck before it significantly impacts delivery timelines. Unlike cycle time, which analyzes completed tasks retrospectively, WIP Aging provides real-time visibility into current work, making it the single most actionable metric for proactive flow management.
The power of WIP Aging lies in its ability to surface risks immediately. The longer a task ages in the workflow, the higher the probability that it will become obsolete for the business, accumulate dependencies, or lose its value entirely. By monitoring aging work continuously, teams can intervene before cycle times balloon and while there’s still opportunity for corrective action.
Understanding WIP Aging Fundamentals

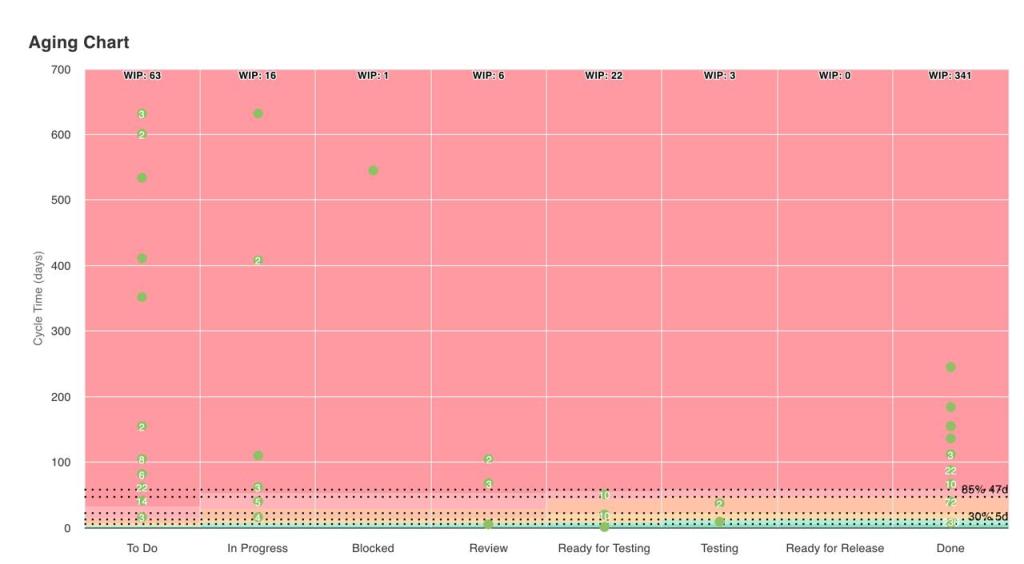

The definition of when work enters “in progress” varies by team, but typically begins when an item is pulled into your active workflow system. From that moment, the aging clock starts ticking. An aging chart visualizes this metric by displaying workflow stages on the horizontal axis and the number of days items have spent in progress on the vertical axis.
The chart incorporates percentile zones—commonly 50th, 70th, 85th, and 95th percentiles—representing historical completion patterns. These zones function as health indicators: if a work item’s age surpasses the 85th percentile, it’s taking longer than 85% of previously completed work at that stage, signaling potential trouble. Research shows that items positioned above the 95th percentile are at high risk and demand immediate attention.
Why WIP Aging Matters More Than Other Metrics

WIP Aging stands apart as the most crucial metric for teams beginning their flow measurement journey because it’s the one metric teams can directly influence in real-time. While lead time, cycle time, and throughput are valuable, they represent lagging indicators—measuring what has already happened. WIP Aging, by contrast, is a leading indicator that enables intervention while work is still active.
Consider the relationship between metrics: if tasks age excessively in the process and complete only after prolonged delays, cycle time metrics will skyrocket. However, by the time elevated cycle times become apparent, the damage is done. WIP Aging catches these issues early, allowing teams to take corrective action before delivery commitments are jeopardized.
Additionally, all other flow metrics improve as a byproduct of effectively managing WIP Aging. Teams that gain control over aging work naturally see improvements in cycle time, lead time, and throughput without explicitly targeting those metrics.
Common WIP Aging Patterns and Their Implications

Teams encounter several distinctive patterns when analyzing aging charts:
Steady Growth: WIP Aging increases uniformly across the workflow, indicating a stable process with appropriate WIP limits. This pattern suggests the team has achieved predictable flow.
Plateau or Congestion: Aging accelerates sharply at specific workflow stages, revealing bottlenecks or oversized work items requiring decomposition. Research shows bottlenecks occur when a stage’s capacity cannot handle incoming workload, disrupting flow and extending lead times.
Wave-like Fluctuations: Periodic acceleration in aging suggests external dependencies or team instability issues. These patterns often indicate work waiting on third-party inputs or resource availability problems.
Exponential Growth: A clear signal of WIP overload, where new tasks start faster than existing ones complete. This pattern indicates violated WIP limits and requires immediate intervention to restore flow.
Task Decomposition Signals: When aging indicates stuck work items, best practice dictates breaking them into smaller, more manageable pieces. Research confirms that similarly sized work items stabilize flow and improve process metrics.

Slice work items into smaller (yet end-2-end) pieces
Integrating WIP Aging with Other Flow Metrics
While WIP Aging provides the most immediate insights, combining it with complementary metrics creates a comprehensive understanding of workflow health.
Lead Time represents the historical Service Level Agreement (SLA)—the total time from customer request to delivery. It encompasses both waiting time and active work time, providing the customer’s perspective on responsiveness.
Cycle Time measures only the active work phase, from when a team begins a task until completion. This metric isolates team efficiency from external factors and queue times.
Throughput quantifies completed work items per time period, directly measuring team delivery capacity. Combined with WIP Aging, throughput helps forecast future capacity using probabilistic methods.
The relationship between these metrics becomes clear when considering Service Level Expectations (SLEs). An SLE is a probabilistic forecast—for example, “85% of work items will complete in 10 days or less”—derived from historical cycle time data. WIP Aging enables real-time comparison against this expectation: if an item’s current age approaches the SLE threshold, the team knows it risks breaching their target and can act accordingly.
Practical Application and Tools
Several tools facilitate WIP Aging analysis.
- The Jira Metrics Plugin is a free Chrome extension that generates aging charts from Jira data
- Predictable.Team provides similar visualization capabilities for both Jira and YouTrack exports (not integrated into Jira directly).
When implementing WIP Aging monitoring, teams should establish clear intervention thresholds. Many organizations use the 85th percentile as a trigger point: when items age beyond this threshold, teams investigate root causes and consider decomposition. For teams preferring conservative planning, the 95th percentile provides a safer target.
Best practices for WIP Aging management are:
- Setting WIP limits slightly below maximum team capacity to allow flexibility for unexpected work. Starting with team size plus one to team size multiplied by two as a guideline range, then iterating based on results.
- Using aging data during daily standups to focus attention on at-risk items. This practice transforms standups from status updates to flow management sessions.
- Combining WIP limits with SLEs to create a comprehensive flow management system. WIP limits control input; SLEs establish output expectations.
- Breaking down work items that exceed aging thresholds, particularly those above the 85th percentile. Research demonstrates that similarly sized work items improve flow stability and metric reliability.
- Avoiding rigid enforcement of limits—WIP limits should guide behavior, not create artificial constraints that harm delivery. Context matters: urgent work may justify temporary limit violations if properly communicated.
The Cumulative Flow Diagram Perspective

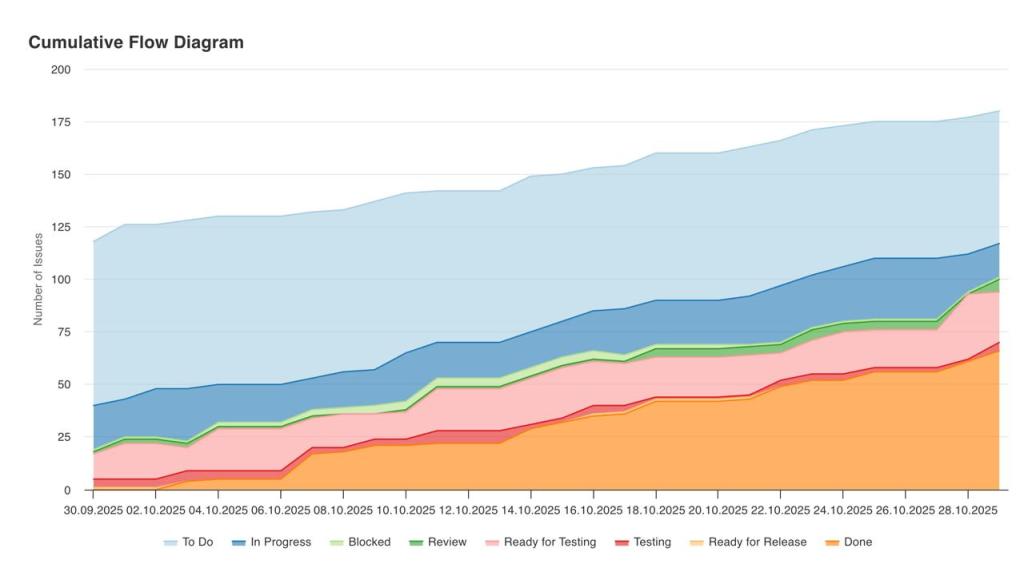

The Cumulative Flow Diagram (CFD) provides an alternative view of WIP Aging through workflow visualization. This chart displays time on the horizontal axis and cumulative work item count on the vertical axis, with colored bands representing workflow stages.

The vertical distance between a band’s arrival and departure lines shows WIP quantity at each stage, while the horizontal distance reveals average cycle time. Parallel bands indicate stable flow; widening bands signal bottlenecks; narrowing bands suggest underutilized resources. The CFD effectively displays three core metrics—WIP, cycle time, and throughput—on a single visualization.
Moving Beyond Synthetic Data (!)
A critical principle when working with flow metrics: never simulate or create synthetic data for analysis or visualization. Fabricated data provides false legitimacy and renders analysis useless. If real data is unavailable, acknowledge this limitation rather than generating representative numbers based on high-level trends. The trustworthiness of flow metrics depends entirely on their foundation in actual workflow data.
Starting Your WIP Aging Journey
For teams beginning flow measurement, WIP Aging offers the most immediate value.
- Start by establishing your workflow boundaries—when does work enter “in progress” for your context—then begin tracking elapsed time from that point.
- Monitor your aging chart daily, ideally during team synchronization meetings. When items approach or exceed the 85th percentile, investigate causes: Are items too large? Are dependencies blocking progress? Are team members overcommitted?
- As patterns emerge, your team will develop intuition about healthy versus problematic aging.
This understanding enables proactive flow management, preventing issues before they cascade into broader delivery problems. Combined with cycle time analysis for retrospectives and throughput data for forecasting, WIP Aging creates a complete flow measurement framework that drives continuous improvement.
