Monte Carlo Simulation: Forecasting Throughput and Project Timelines

TL;DR: Forecasting team Throughput is super-easy and much more reliable than traditional methods, if you limit your work in Progress. Reliability confirmed by research data.

We’ve already extensively covered Throughput (one of the flow metrics), how to analyze Throughput data from 3 key angles. And why it’s better for forecasting than storypoints.

Now let’s get to essentials and practical questions that our management looooves to ask: “When will you guys finish this project of X items”?

Foundations of Probability-Based Forecasting

Any forecast always involves 3 essential bits:

  • Probability
  • Spread
  • Assumption that future work resembles historical patterns

Saying “This epic (10 tasks) will take exactly 6 weeks” is misleading. A more accurate forecast: 10 tasks in 5–7 weeks, where:

  • 5 weeks = 50th percentile (half of runs finish by then)
  • 7 weeks = 85th percentile (85% of runs finish by then)

How Monte Carlo Simulation Works

Disclaimer: Here and further on I’ll be using charts built with Predictable.team (my vibe-coded react app that visualises and forecasts team performance based on Jira / Youtrack CSVs).

Let’s imagine that we need to understand when will the next 10 items be ready.

1. Collect historical throughput data

  • Imagine you have information about how many items your team finishes every day for a consistent period of time. Always count all days, including the ones with 0 deliveries.
  • Let’s say our dataset is 90 days. A random number should be generated in the range from 1 to 90, because each of those randomly generated numbers represents a day from that dataset.

2. Run 1,000–10,000 simulated scenarios. For each simulation (code sample below):

  • Generate random number.
    • This random number will represent a day from our stats (one of those 90).
  • Record how many items have been delivered during that day
    • Let’s say we got 20, and on 20th day from our dataset we’ve delivered 1.
    • That means that so far we have 1 item delivered.
    • Continue generating random numbers until you get 10 (since we wanted to know when we’ll deliver next 10 items).
    • Voila, your first scenario is ready. Thousands more to go!

3. Display a probability distribution of completion times

  • Take a look at 50th pp (50% of simulations had 10 items be finished at this number of days or less).
    • You can plan at 50th pp as long as you have WIP limits and control aging within your system.
  • Take a look at 85th pp (85% of simulations show that 10 items would be delivered by that day)
    • 85th pp is a conservative estimate, which strikes great balance between risk and speed.
  • You can also forecast saying 50pp-85pp as a range, since all forecasts have range, probability and assumption that our work would be similar in the future.

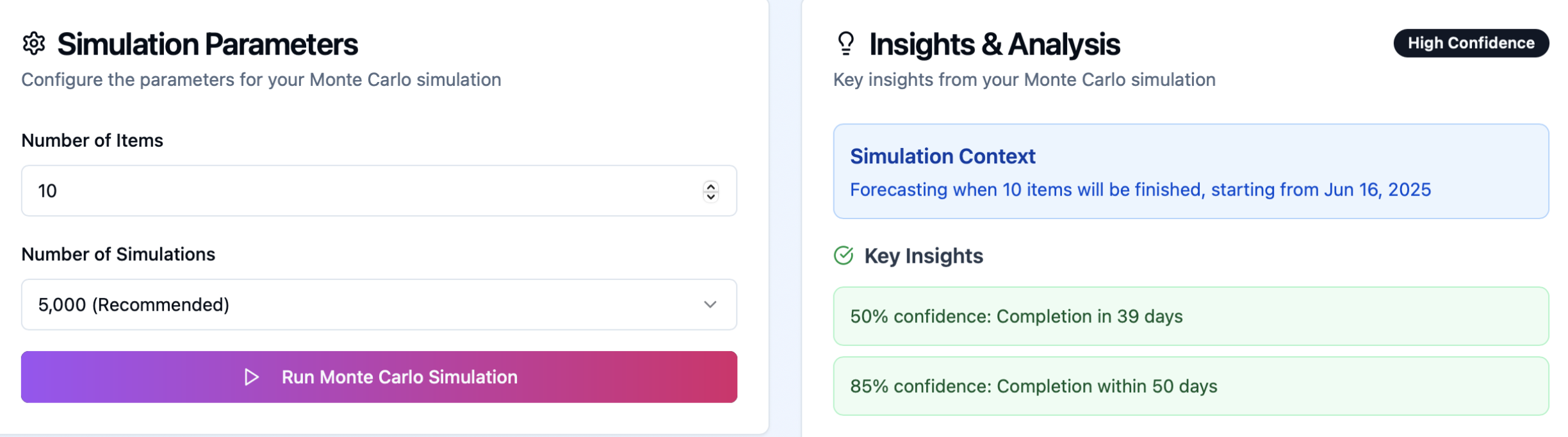

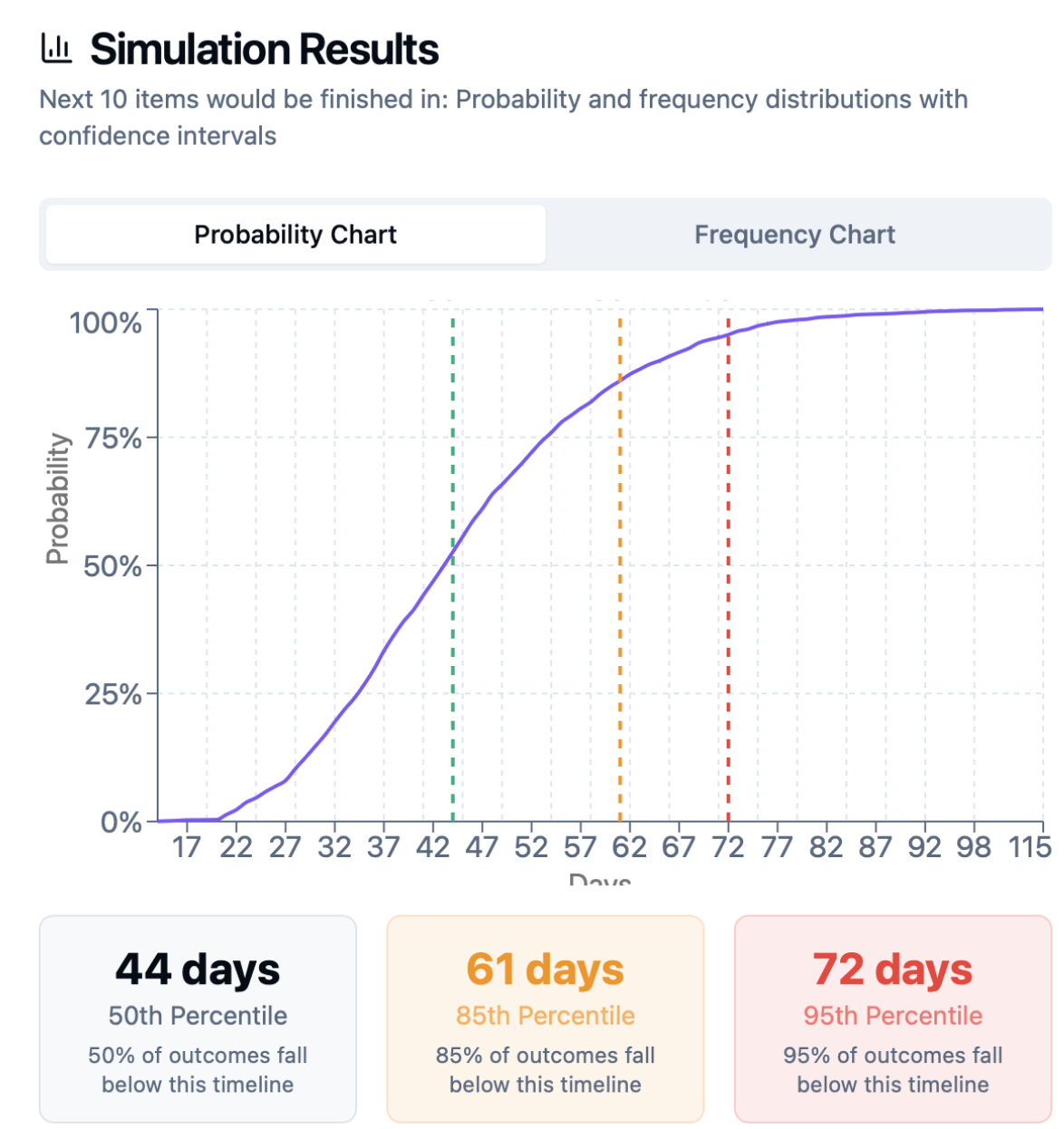

Example for 10 tasks:

  • 50% probability: 39 days
  • 85% probability: 50 days
  • 95% probability: 58 days

Present to stakeholders: “Forecast: it will take 39-50 days.” Using the 85th percentile offers a safer buffer, though planning at the 50th percentile is common practice.

Factors Affecting Forecast Quality

  • Task breakdown: End-to-end slices yield better forecasts than component-only slices.
  • Historical window: Avoid using data older than six months.
  • Zero-throughput days: Include them to reflect weekends, holidays, sick days.
  • Calendar vs. work days: Always use calendar days to account for non-working periods.
  • Also: Garbage-in, Garbage-out. If your data is bad, not full

WIP is essential for reliable forecasting

Monte Carlo forecasts require enforced WIP limits. As Daniel Vacanti warns:

“No WIP limit = no flow, which means no predictability.”

Forecasting should always be updated

Run fresh simulations every 1–2 weeks to adapt to changing conditions. Just like during weather forecasts on forest fires, earthquakes, traffic forecasts and other systems, we can’t and never will account for all parameters in the equation, hence we need to update our forecasts using our latest data.

Are there better models than just random MCS sampling?

Prateek Singh of ActionableAgile made a research proved that explained here “random” method actually produces the best forecasting results compared to more sophisticated day-matching algorithms.

You can read the research at the link above or watch recent their episode of Drunk Agile (kudos for the guys on that name):

Why Throughput Works

By the law of large numbers, sufficient throughput history smooths out random variation in work size and type, converging on a stable average performance metric.

That’s applicable not only in relying on Throughput and forecasting via MCS (Monte-Carlo Simulation), but thinking about outcomes of you DnD fights 🙂

Nifty things

Monte-Carlo Forecasting tools

  • Predictable Team – safe stateless web app. Ingests CSV / XLSX from jira and youtrack. Visualizes Throughput from the file + performs Monte-Carlo Simulation based on your data (When will be project finished, how many items to take in a sprint, when will the epic be done).
  • TWIG from Actionable Agile. Super-awesome app that is de-facto industry standard together with getNave. Visualizes metrics + does MCS.

Some reading references
